An update on the City of Edmonds’ efforts to revitalize the Highway 99 corridor — including news of additional costs and environmental review requirements — was among the items presented during three virtual city council committee meetings on Tuesday.
The 2.3-mile Edmonds section of Highway 99 runs from 244th to 212th Streets Southwest and also includes portions owned by Snohomish County (unincorporated Esperance), and the cities of Mountlake Terrace and Lynnwood. When Edmonds launched the revitalization effort in 2018, the plan was to complete the project in segments over 15 years. Two stages have been completed: Stage 1, which involved overall corridor planning, and Stage 2, which included installation of center medians, a specialized HAWK pedestrian signal and signage at either end of the corridor.
Tuesday’s presentation at the council’s parks and public works committee — with Councilmbers Susan Paine and Michelle Dotsch — focused on the next two segments: Stage 3, which runs from 244th Street Southwest — at the Edmonds/Shoreline border — to 238th Street Southwest, and Stage 4, which goes from 224th to 220th Streets Southwest.
Improvements planned during the next two stages include the addition of sidewalks, bike lanes, landscape buffers, stormwater treatment, street/pedestrian light poles and capacity improvements at the 238th and 220th signalized intersections. There will also be opportunities for artwork in the segments along the corridor, which includes three districts: the Gateway, International and Health Districts.
The city started the design for Phase 3 last year, and City Transportation Engineer Bertrand Haus said that there have been some “notable changes” since then. The city council in March 2023 approved the addition of separated bike lanes on both sides of the entire corridor to comply with Washington State Department of Transportation (WSDOT) Complete Streets requirements, along with the addition of bike lanes along 238th Street from Highway 99 to 84th, and an “active transportation path” along 220th that connects Highway 99 to the Interurban Trail.
Haus then turned it over to Scott Sawyer of consultant SCJ Alliance, who explained how research into the chemical 6PPD-quinone — which in 2020 was identified as toxic to adult salmon — will be impacting the Highway 99 revitalization work. Dust from vehicle tires contains the chemical, which is used to slow tire degradation. The dust is washed into stormwater systems “and eventually into salmon-bearing streams,” Sawyer said.
In 2022, the U.S. Department of Fish and Wildlife and the National Marine Fish Services began requiring that all roadway projects go through a “formal consultation” process, which will add two years of review time to the environmental approval process, Sawyer said. The only exception is if an entity can prove it is able to infiltrate all of a project’s stormwater so it doesn’t end up in local waterways.
WSDOT is working with federal agencies on new programmatic guidance in an effort to reduce schedule impacts, and the State Department of Ecology is developing stormwater manuals that could be out this year, he said.
“The current design for the projects are going to be done in compliance with that expected manual,” Sawyer said, although he added it’s possible that the manual may be challenged in court by advocacy groups.
As a result, “there are different factors that come into play with the (Highway 99 project) schedule,” Haus said. “The environmental is going to take a little longer.” Right-of-way acquisition is also expected to take a while, since “there are a lot of parcels in both (Phase 3 and 4) projects,” he added. Design and right of way are currently scheduled to be completed in 2027 for Stage 3, and in 2028 for Stage 4, with construction of Phase 3 completed in 2029 and Phase 4 in 2030.

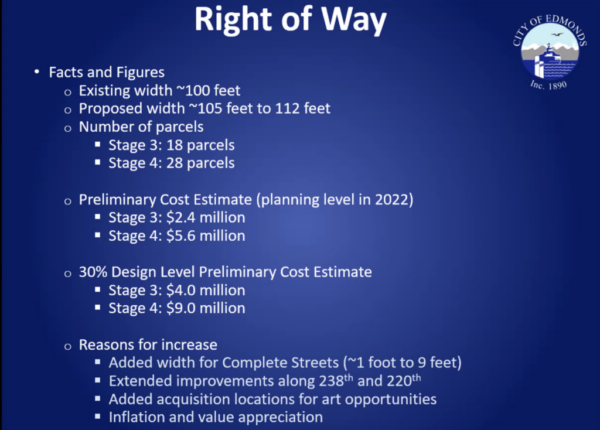

Cost estimates for right-of-way acquisition have increased due to the need for wider roadways to accommodate bicycle lanes and extended improvements along 238th and 220th Streets Southwest, the addition of locations for artwork and “inflation and value appreciation,” Haus explained.
Compared to preliminary cost estimates in 2022, recent figures at 30% design indicate that the costs have nearly doubled.
The council still has to make a decision about whether to convert overhead utilities to underground. This conversion would be fully paid by certain utility companies, such as Comcast and Wave, while other utility providers — like Snohomish County PUD and Ziply — might provide the city with partial credit for the conversions.
Assuming such credits, the total preliminary cost for undergrounding the utilities would be $5.8 million for Stage 3 and $8.4 million for stage 4.
City Engineer Rob English explained that Stage 3 — estimated at $26.5 million, including utility undergrounding — is funded through State of Washington Connecting Washington and Move Ahead Washington initiatives, plus local real estate excise taxes. Stage 4, meanwhile, has so far received funding from federal grants, State Connecting Washington funds and traffic impact fees.
English said that staff has requested that $22.5 million in Move Ahead Washington funds for Stage 3 — currently programmed for 2031 — be shifted ahead to earlier years, to help fund the right-of-way acquisition phase (2026) and the construction phase (2028). That is currently in the state’s supplemental budget, awaiting the governor’s approval.
Stage 4 is a more expensive project, estimated at $35.7 million (also including $8.4 million in utility undergrounding). As for funding, “we have a bigger gap on this project,” English said, pointing to a shortfall of $2.2 million for the right-of-way phase and $22.1 million for construction.
A presentation on the Highway 99 revitalization project is scheduled for next week’s city council meeting.
